RIBA Fee Scale: A Guide for Bespoke Residential Projects
- Harper Latter Architects

- 2 hours ago
- 10 min read
The old RIBA fee scale was abolished in 2009, so there isn't a live, compulsory tariff sitting behind your architect's quote today. That's the key shift to understand before you compare numbers, because the phrase still appears everywhere while the system behind it has become practice-specific, stage-based, and negotiable.
For a homeowner planning a bespoke house, a major refurbishment, or a basement extension, that can feel confusing at first. One architect may quote a percentage of construction cost, another may offer a fixed fee, and a third may break the work into stages with different levels of service. The language can sound formal, but the core is much more practical: you're buying design time, technical coordination, planning support, site administration, and risk management, not a regulated price chart.
Why the RIBA Fee Scale Still Shapes Every Conversation About Architect Fees
A Wimbledon family comparing quotes for a new build or a large extension will still hear the phrase RIBA fee scale within the first conversation, even though the old compulsory chart no longer exists. That's because the terminology survived the system it came from, and many practices still use RIBA work stages, indicative percentage bands, and stage allocations when they explain fees. The phrase feels official because it once was.
The important thing is to separate historical authority from current pricing practice. Today, a fee letter is usually a proposal from one practice, not a regulated tariff. That means two architects can quote very different figures for what sounds like similar work, especially on private residential schemes where the brief, site constraints, heritage issues, and level of service all change the workload.
What that means in plain English
If you search for a fixed RIBA fee scale, you're really looking for a way to benchmark a quote, not a law that sets it. The practical question is whether a proposal covers the right stages, the right deliverables, and the right level of involvement for your project. A low headline figure can look attractive, but it's only useful if you know what's included and what's missing.
Practical rule: compare fees by scope, not by headline number alone.
That's why this topic still matters. Once you understand how fees are built, you can ask better questions, compare proposals on the same basis, and avoid paying twice for work that was never fully included in the first place.

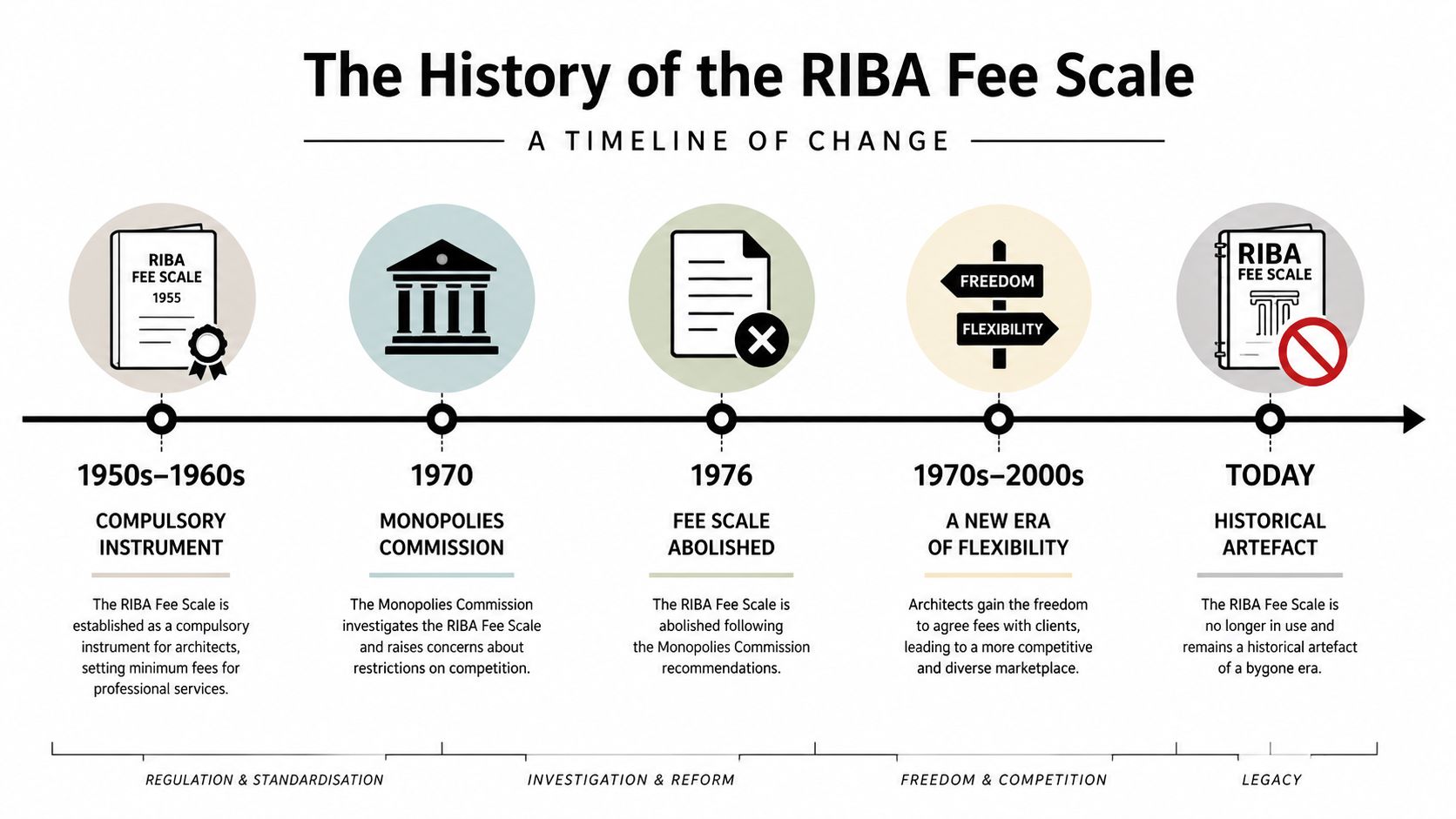

The History of the RIBA Fee Scale and Why It Was Abolished
The story begins with a system that was once embedded in UK professional life. RIBA's fee scales were compulsory for more than a century, then the structure began to unravel under competition-law pressure, becoming “recommended” in 1982, “indicative” in 1992, and finally abolished in 2009. The 1970 Monopolies Commission report was a key turning point because it argued that price competition would encourage efficiency, innovation, and variety in architectural services.
That timeline matters because it explains why older references can still sound authoritative. Many clients assume percentage charts are a living rulebook, when in fact they're a historical residue from the period before UK architects had to price work individually. The old model was based on a percentage of construction cost, but the profession no longer works inside a prescribed tariff.

Why the abolition still affects today's quotes
The practical consequence is simple. Because the scale was dismantled, architects now calculate fees case by case, which is why similar homes can produce noticeably different proposals. That's especially true for private residential work and bespoke projects, where planning risk, existing structure, neighbour coordination, and design ambition all alter the amount of professional effort required.
RIBA itself later described percentage-based fee charts as increasingly outdated and potentially harmful in the economic climate of the time, which reinforces the point that the old system wasn't just removed, it was replaced by a more flexible market approach. In other words, “RIBA fee scale” now works as shorthand for an old way of thinking about fees, not a live regulated scale.
How UK Architects Actually Calculate Fees Today

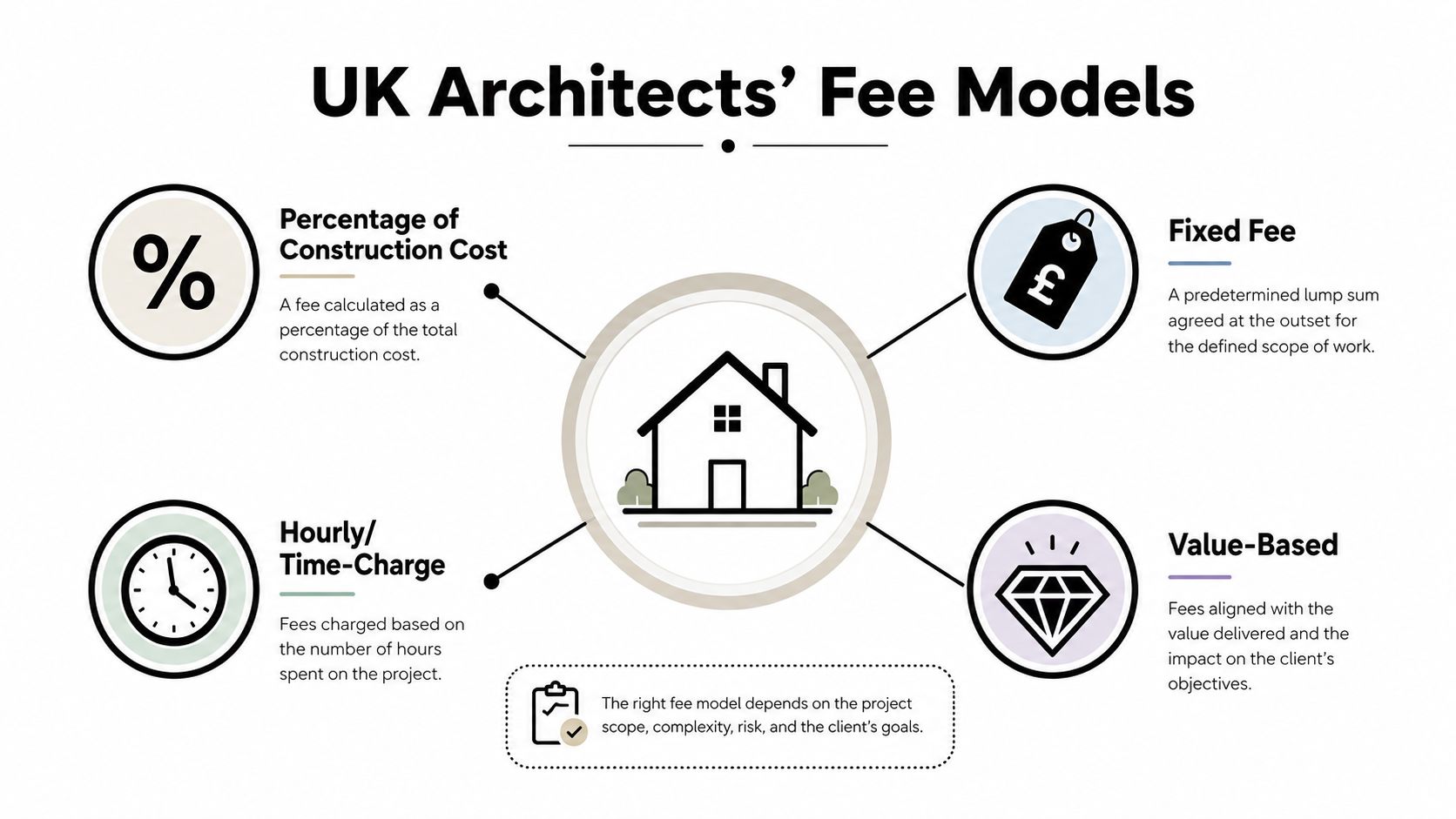

Modern fee proposals usually start with one of four models. The most common is a percentage of construction cost, but many practices also use a fixed fee, an hourly or time-charge rate, or a value-based, scope-led approach. Which model gets used depends on how clear the brief is, how predictable the project is, and how much risk the architect is taking on.
The four pricing models in practice
A percentage fee suits projects where the construction budget is reasonably defined, such as a large new build or a full-service residential commission. It's easy to understand and it scales with project size, but it can be misleading if the scope is unclear. A fixed fee gives more budget certainty, which is helpful when the brief is tightly defined, though the architect bears more risk if the design changes.
Hourly or time-charge pricing works better when the scope is uncertain, when you want early-stage advice, or when you're paying for a defined block of professional time rather than a complete service. Value-based pricing is less about the construction sum and more about the outcome, the complexity, and the responsibility being carried. That approach is often used for bespoke homes because a difficult heritage site, for example, can demand far more work than a simpler building of the same value.
The framework underneath all of this is the RIBA Plan of Work, with stages 0 to 6 covering feasibility through to handover. Many fee proposals are built around those stages so the client can see when money is being spent and what service is included at each point.
The architectural process is often set out clearly in practice guidance, and a useful overview of how a project moves from briefing to completion is available in Harper Latter Architects' design process guide.
How to read a fee proposal
Look for the model first, then the stage breakdown, then the exclusions. If a proposal doesn't say how it handles redesign, planning revisions, site visits, or additional consultant coordination, ask before you agree.

Typical Percentage Ranges by Project Type
The percentage number itself matters less than the type of project it applies to. A new house on a clear site is not the same as a refurbishment, and neither is comparable to a listed-building repair with conservation constraints. That's why the same headline percentage can feel fair in one commission and expensive in another.
What the UK residential ranges usually look like
One residential fee guide citing Mirza & Nacey survey findings gives a useful benchmark for full-service work. It points to 7.5% to 12% for new private houses, 10% to 12.5% for refurbishments and extensions, and a higher percentage again for repair and conservation work on historic buildings, where design coordination and statutory compliance tend to increase. Those figures are indicative, not compulsory, but they remain widely referenced because they match the workload differences clients see in practice. See the discussion in Thor Architects' fee guide.
The reason heritage and complex retrofit work sits higher is straightforward. Existing buildings bring more unknowns, more consultant input, more coordination with planning and building control, and more on-site problem-solving. A basement extension or a conservation project can look simple on paper and still absorb far more professional time than a conventional new build of similar size.
Comparing project types side by side
Project Type | Indicative Fee Range | Why It Sits There |
|---|---|---|
New private house | 7.5% to 12% | Clearer scope, but full-service design and technical delivery still take real time |
Refurbishment or extension | 10% to 12.5% | Existing structure, planning constraints, and coordination increase effort |
Repair or conservation work | Higher again | Heritage sensitivity, statutory requirements, and on-site complexity raise the workload |
A separate RIBA-derived guide also shows that fee curves change by building type and that those scales are not compulsory, which is another reminder that a percentage is only a starting point, not a verdict. The same square footage can be priced differently depending on whether the project is a simple dwelling, a complex extension, or a heritage retrofit, as shown in the RIBA fee guide graphs.

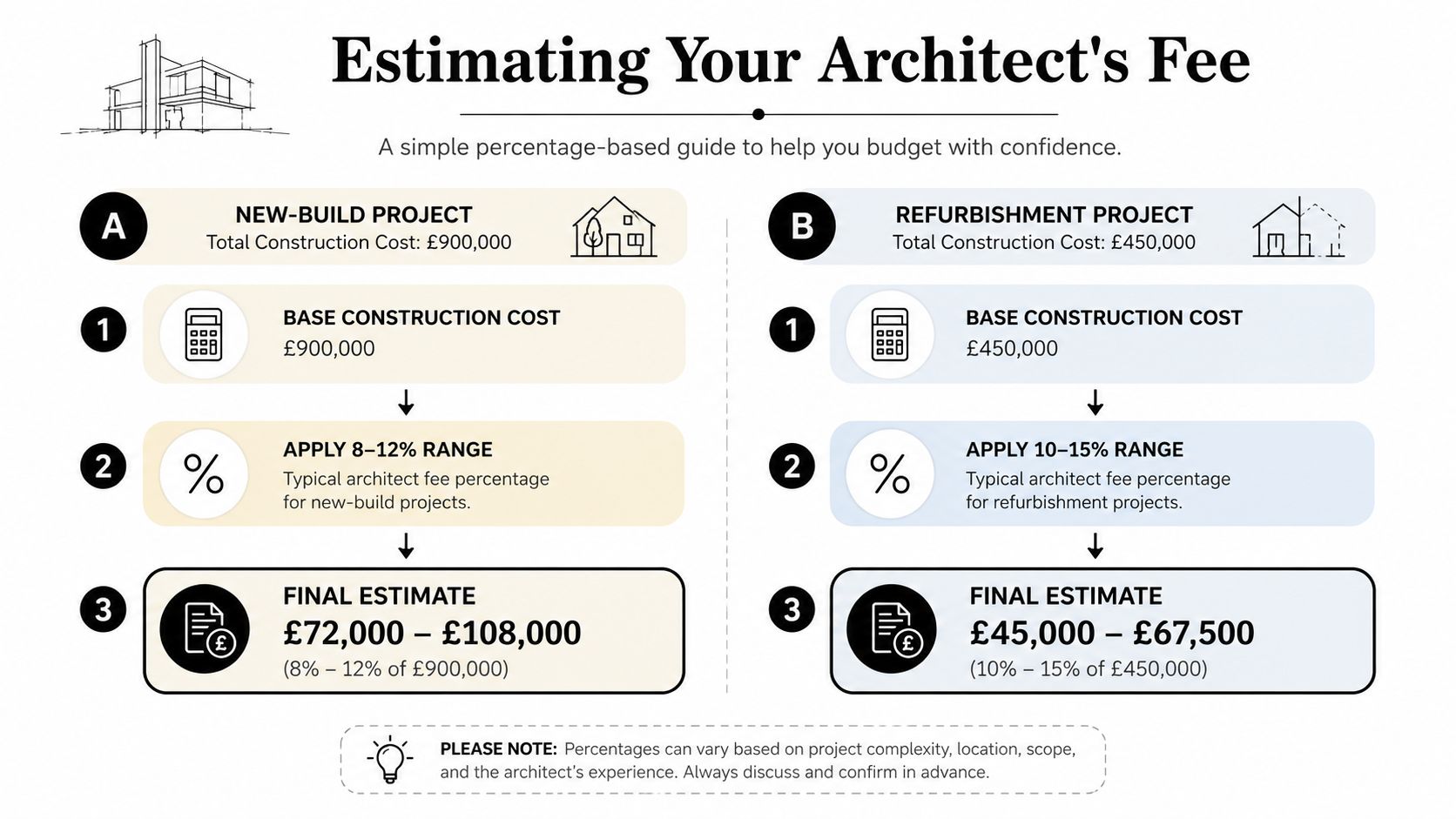

Worked Examples and How to Estimate Your Own Fee
The easiest way to test a fee quote is to turn the percentage into a staged estimate. That's where the old habit of thinking in one lump sum causes confusion, because architects usually spread their work across RIBA stages 0 to 6. RIBA homeowner guidance says a typical split is 35% for stages 0 to 3, 35% for stage 4, and 30% for stages 5 to 6. See RIBA's homeowner guidance on calculating fees.
Example one, a £900,000 new build
If you're budgeting for a £900,000 new-build house, a fee in the 7.5% to 12% range would produce a broad overall estimate. That gives you a working band before you ask for a formal proposal, and the stage split lets you see how payments are likely to land over the life of the project.
Using the RIBA stage split, you can think of the fee in thirds. About 35% is tied up in early work like feasibility, concept and planning, another 35% sits in technical design, and the remaining 30% covers construction through handover. The practical result is that you should expect invoicing to follow progress, not wait until the end.
Back-of-envelope rule: construction value × indicative percentage × stage weighting.
Example two, a £450,000 refurbishment and extension
For a £450,000 refurbishment or extension, the relevant range is typically higher than a new build because existing buildings demand more coordination. That means the same stage logic still applies, but the proportion of time spent on technical design and site problem-solving can feel heavier to the client because the project is more changeable.
A useful way to check a proposal is to ask whether the fee covers planning support, technical coordination, and site administration in full, or only in part. That distinction matters because the cheapest quote can become expensive if redraws, revisions, or site-stage support are extra.
An example of how a firm can describe project cost and fee thinking in extension work is set out in Harper Latter Architects' extension cost guide.

Percentage vs Fixed Fee vs Hourly Models
A percentage fee is familiar, but it isn't automatically the fairest option. UK review material notes that architect charges can commonly fall between 3% and 15% of total construction costs, and that fees generally decrease as the budget rises because of economies of scale, which is another reason small and large projects should not be judged by the same yardstick. See MATA Architects' overview of UK architect fees.
Where each model works best
A percentage fee is easiest to read when the budget is known and the scope is likely to stay stable. A fixed fee gives you clearer budget certainty, but only if the brief is tight and everyone agrees on the service boundaries. An hourly model is useful for early advice, troubleshooting, or advisory work where the final amount of effort can't be pinned down yet.
The hidden risk with a low headline percentage is that it may exclude the difficult parts. Redesign iterations, planning resubmissions, contract administration, principal designer duties, BIM requirements, and extra consultant coordination can all sit outside a stripped-down quote if you don't check carefully. That's why a low fee is not automatically a good fee.
A simple comparison
Percentage fee: Best when the scope is defined and the build cost is the main budget anchor. Watch out for exclusions and extra services.
Fixed fee: Best when you want a set number from the outset. Watch out for changes that trigger variations.
Hourly rate: Best when you need flexibility or short, defined interventions. Watch out for the total becoming hard to predict.
A public-sector schedule from England shows how this can be handled in a more structured way, with overall architect fees for RIBA stages 1 to 6 set at 10.5% of construction value, capped at £60,000, alongside hourly rates of £85 for an architect and £130 for a higher-grade role. That schedule also weights the work across stages to control risk, as shown in the published fee schedule.
How Harper Latter Architects Price Bespoke Residential Projects
For bespoke homes, a pure percentage quote rarely tells the full story. Harper Latter Architects describes a rigorous 8-step process, from free initial consultation through completion, and that kind of staged service is a better fit for complex residential work than a single flat number. Fee proposals for new builds, luxury refurbishments, basement extensions, and conservation projects are therefore tied to the work being done at each stage.
Why scope-led pricing suits high-end homes
Bespoke residential projects often combine architectural design, interior planning, technical coordination, and site-stage problem-solving. A scope-led proposal lets the practice price those parts separately or in combination, which is more honest than forcing every commission into one percentage mould. It also helps the client see where the fee goes when the brief includes features such as staircases, joinery, garden rooms, or heritage-sensitive detailing.
The practical advantage is clarity. A client can compare the number of meetings, drawings, consultant coordination, and on-site involvement rather than just staring at a single figure. That's especially useful in South West London and Surrey, where planning sensitivity and existing-building complexity often change the amount of professional effort required.
A full overview of the service areas and deliverables sits in Harper Latter Architects' services guide.
A good residential fee proposal shows the design process, the stage split, and the exclusions before it shows the headline number.
Commissioning an Architect and Negotiating Fees With Confidence
Start with a brief that is specific enough to compare. Tell each practice the project type, the level of design ambition, whether planning support is needed, whether the site is occupied, and whether you want site-stage administration included. If you leave those points vague, the quotes will be vague too.
Five questions every fee letter should answer
What is included? Ask for a plain list of stages and deliverables.
What is excluded? Look for planning re-submissions, extra visits, and consultant coordination.
How are stages billed? Check whether invoices follow progress or dates.
What happens if the brief changes? Ask how variations are priced.
What rates apply to extra work? Request hourly rates for additional services.
A low quote can hide missing technical design or thin contract administration, and that tends to show up later as delay or extra cost. If two proposals look similar but one is noticeably cheaper, check whether one of them has reduced the scope.
Small negotiation moves that help
Ask for staged invoices if cash flow matters. Clarify who is acting as principal designer and whether BIM or sustainability support is included. Then compare like-for-like, not apples with oranges. The best comparison is not the cheapest quote, it's the quote that fully covers the service you need.
If you want a clearer sense of how a practice structures project services around a residential brief, visit Harper Latter Architects and review how its bespoke residential process and service structure align with the kind of fee questions covered here.
