Cost to Build an Extension in the UK

  • Writer: Harper Latter Architects
    Harper Latter Architects
  • Jul 27
  • 11 min read

You can stand in a Wimbledon kitchen with tape measure in hand, looking at the back of the house and doing the same mental arithmetic most homeowners do. A rear extension would transform the room, but the first quote you see online rarely matches the number you end up living with. The cost to build an extension in South West London is shaped by far more than floor area, and the gap between the headline rate and the all-in budget is where most surprises sit.


That gap matters because the same extension can look affordable on a builder's rate sheet and expensive once the actual project costs land. The build price is only one part of the story. Professional fees, approvals, VAT, party wall work, ground conditions, and contingency all sit outside the neat per m² headline that homeowners tend to compare first.


Why the Headline Extension Cost Is Never the Whole Story


A Wimbledon owner may begin with a simple brief, a rear kitchen extension, a better connection to the garden, perhaps a utility room tucked to one side. Then the first number arrives, usually quoted as a per m² build rate, and the conversation changes quickly. That rate is useful, but only if you know what sits inside it and what has been left out.


In practice, the headline number often describes the construction contract, not the total project budget. It may cover the shell, finishes, and basic fit-out, but it usually leaves out the things that make a real extension work in the UK market, especially in South West London. That is why two projects with the same floor area can feel wildly different once fees, VAT, and external works are included.


For a homeowner comparing options, the right question is not just, “What does a square metre cost?” It is, “What is missing from this quote, and what will the final all-in budget become once the rest of the team is involved?” A useful starting point is the wider cost context in our guide to wraparound extension cost, because wraparound projects often reveal the same budgeting blind spots in a more complex form.


Practical rule: if a quote looks comfortably low, check whether it is a build-only figure, a shell-only figure, or a real all-in allowance.

That is the lens I use with clients in Wimbledon, Raynes Park, and across SW London. The headline number is the opening line, not the conclusion. The rest of this guide breaks down what the per m² rate means, where the money goes, why London projects cost more, and how to set a budget that can survive planning, design development, and the build itself.


Understanding Per Square Metre Extension Costs in the UK


A per m² figure is useful, but only as a starting point. In the UK, a single-storey extension is often priced in the region of £1,800 to £3,000 per m², while some guidance sets a slightly higher working range of £2,200 to £3,300 per m² excluding VAT for the same type of project, as set out by MyJobQuote and Homebuilding & Renovating. Those numbers make sense because finish quality, structural complexity, and location all push the figure up or down.


What the rate usually means


A proper quote should spell out the build scope in plain English. In practice, that usually covers the shell, the structure, the envelope, internal finishes, and enough fit-out for the extension to be usable. It does not mean the full project is covered, and that is where budgets often go off course.


For a 30m² single-storey extension, industry guidance commonly puts the build cost at £66,000 to £99,000 before VAT, and the same example is used in Homebuilding & Renovating's guidance, which also notes that VAT at 20% sits on top of the build figure. That gap is enough to change the shape of the whole budget once the rest of the project team is involved.


The same point applies to smaller schemes. HOA's homeowner guidance says a standard 20m² single-storey house extension averages £48,000 plus VAT and repeats the £1,800 to £3,000 per m² rule of thumb (HOA). The size benchmark is helpful, provided you keep VAT separate from the build figure.


What is usually excluded


The expensive surprises are usually the items that sit outside the headline rate. VAT is one. Professional fees are another. Structural design, Party Wall matters, planning and building control, abnormal groundworks, and contingency can all sit beyond the number quoted online. Consumer guides often stop at the construction figure, so the price you see on a page is rarely the amount you should set aside in your bank account.


A realistic extension budget has to be read in layers, not as one flat line. That is especially true in South West London, where the headline build rate can look manageable until fees, approvals, and site constraints are added. If you want to see how those wider costs show up in a more complex project, the cost logic is similar to the one set out in our guide to wraparound extension cost.


A Line Item Breakdown of an Extension Budget


An infographic detailing the typical cost split for a 30m² single-storey extension.


A 30m² rear extension in Wimbledon rarely fails because one item is wildly wrong. It fails because several ordinary items add up at the same time. Demolition, foundations, steelwork, roofing, glazing, first fix, second fix, and external works all want a share of the budget, and some of them are less visible than homeowners expect.


Where the money actually goes


The early spend usually sits in the bits you'll never admire once the room is finished. Demolition and substructure come first, then structure and shell, then the envelope that keeps the building dry and warm. On a typical scheme, the structure and shell are often the most expensive cluster because they carry the building and set the quality floor for everything that follows.


The next cluster is the one clients notice when the quote starts to climb. Large openings, glazed corners, sliding doors, bespoke joinery, and upgraded finishes all push the same area into a higher bracket. That is why two extensions with the same square footage can land in very different totals.


Typical cost split for a 30m² single-storey extension


Cost Category

Share of Build Cost

Indicative Range

Demolition and strip-out

Lower share

Varies by existing structure

Substructure and groundworks

Lower to medium share

Varies by ground conditions

Structure and shell

High share

Often one of the largest clusters

External envelope

Medium to high share

Depends on glazing and roof form

First fix services

Medium share

Varies with heating and services strategy

Second fix and finishes

Medium to high share

Strongly driven by specification

Fit-out and joinery

Medium to high share

Can rise quickly with bespoke items

External works

Lower to medium share

Access, drainage, and landscaping dependent


This split is not a quote. It is a way to interrogate a quote. If the figure looks high, ask which category is driving it. If the figure looks low, ask what has been omitted.


Party Wall process can also sit outside the builder's number, so it's worth understanding the professional side of the budget as early as possible. A clear overview is set out in our note on party wall surveyor costs, because that expense often appears late and catches people by surprise.


Good budgets don't just total the cost, they show the pressure points.

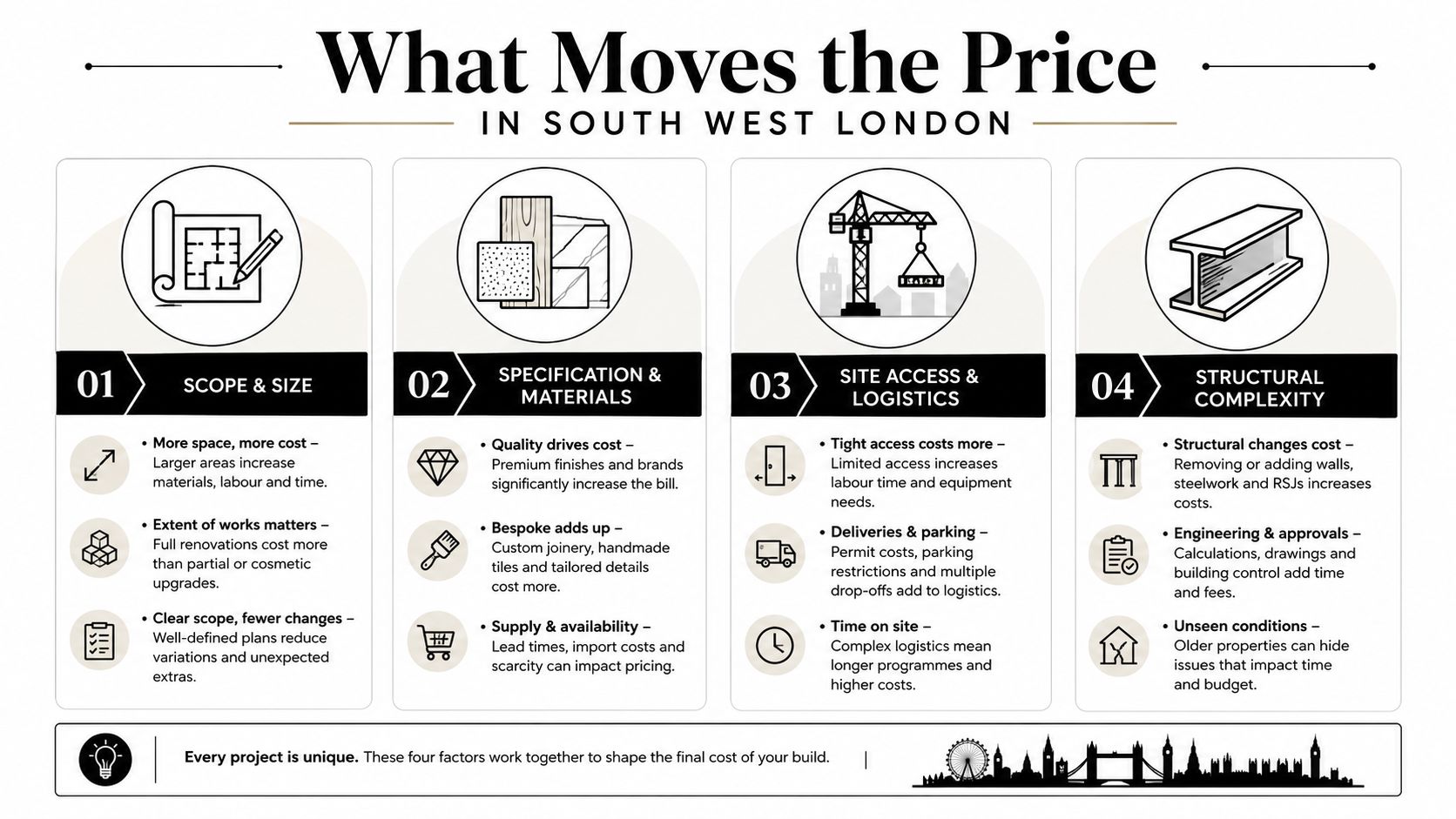

What Moves the Price in South West London


London changes the maths. The Federation of Master Builders guidance quoted in later UK home-extension advice puts London and the South East 25 to 40% higher than the national figure (Lynch Brother Homes summary of FMB guidance). That uplift shows up in labour, logistics, local demand, and the simple fact that more complex projects are common in established South West London streets.


Scope and size are only the start


A bigger extension costs more, but not in a perfectly linear way. A straightforward box-shaped scheme sits in a lower band than a more complex design. Homebuilding & Renovating separates a more straightforward box-shaped extension at £2,200 to £2,500 per m² from a more complex design at £2,800 to £3,100 per m² (Homebuilding & Renovating). That difference comes from geometry, detailing, and the amount of work needed to make the junctions behave properly.


Specification and materials change the unit rate


In Wimbledon and the wider SW London market, the budget moves fast when clients ask for larger spans, better glazing, higher-grade finishes, or custom joinery. A standard rear addition and a lifestyle-led extension are not the same product. Basement extension pricing makes that point very clearly, since UK guides place basement extensions roughly at £100,000 to £160,000 in many cases, and some London-focused guides put premium or inner-London projects at £3,200 to £4,200 per m² (Checkatrade, MyJobQuote). Complexity, not just area, drives that jump.


Site access and heritage constraints matter more than most people expect


A tight side passage, a rear garden with poor access, or a house that needs careful working around existing fabric all adds cost. Heritage status can add another layer because the design team may need to protect original elements, adapt methods, or spend longer coordinating approvals. In practice, that means the same extension can cost more in Wimbledon Village than in a newer, easier-to-work-on setting.


Basements, glazed links, and roof terraces are the classic examples of space types that look simple on paper and expensive on site. They demand more structure, more waterproofing, and more coordination, so the cost per m² rises faster than homeowners expect.

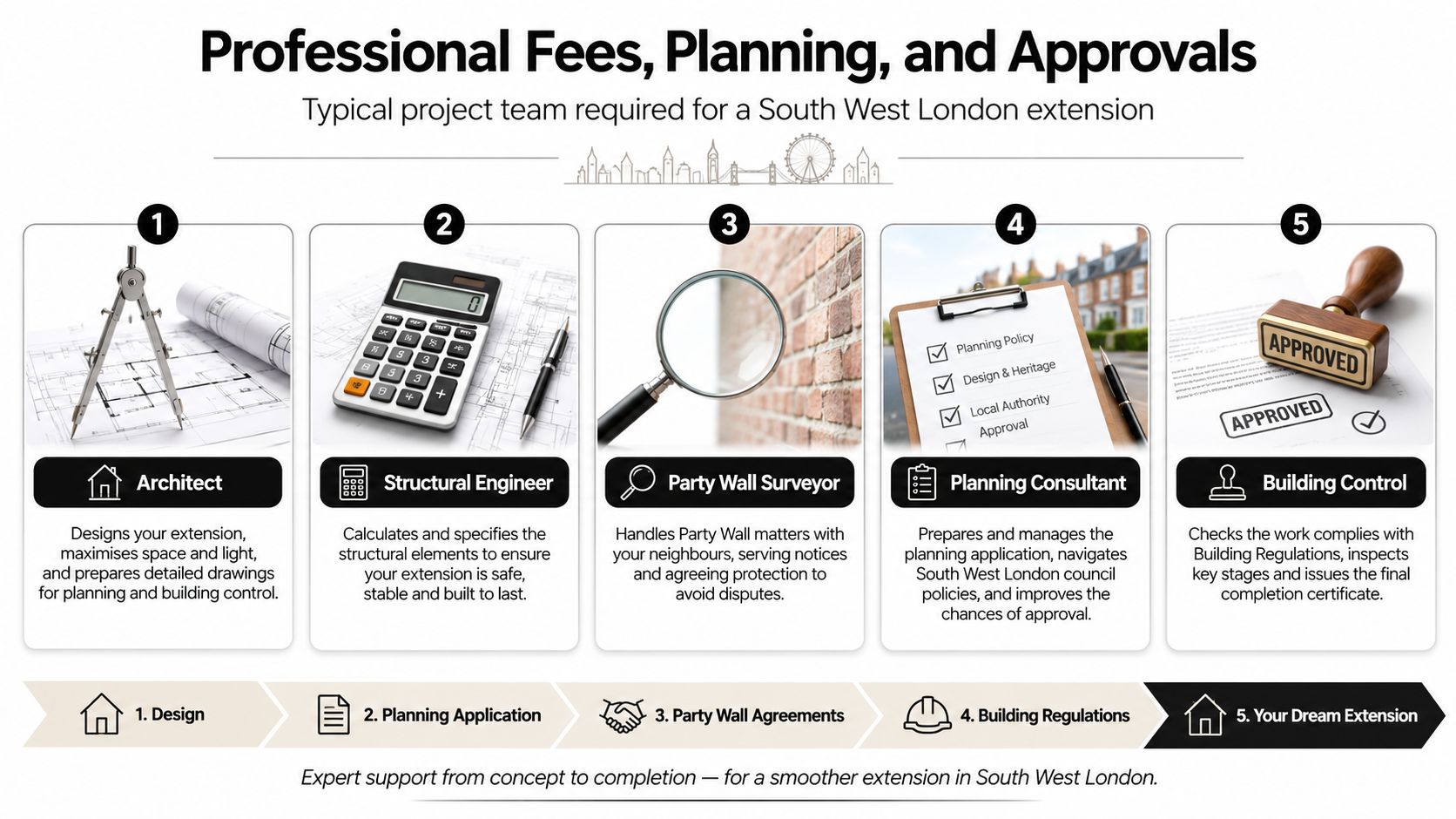

Professional Fees, Planning, and Approvals


An infographic detailing the five essential professionals needed for a home extension project in South West London.


A builder's quote is not the full cast list. A South West London extension often needs an architect, structural engineer, Party Wall surveyor, planning consultant, and building control input, with a quantity surveyor sometimes added when the budget is tight or the brief is more ambitious. Those fees sit beside the build cost, not inside it.


What each professional actually does


The architect shapes the brief, tests the layout, and coordinates the design. The structural engineer makes sure the opening, foundations, and load path are viable. The Party Wall surveyor handles the formal process where shared walls or boundary works are involved, which is common on terrace and semi-detached plots across Wimbledon.


Planning is where many homeowners misread the process. Some projects fall within permitted development rights, but others need a full planning application, especially where scale, site constraints, or policy context triggers extra scrutiny. Conservation areas and listed buildings add another layer, and those steps can change the pace and cost of the entire project. For a plain-language overview of the planning route, see our guide to what planning permission means for extensions.


If the house sits in a conservation area, treat approvals as part of the design, not a box-ticking exercise after the drawings are done.

Why the fees belong in the budget from day one


Consumer guides often leave these costs out, yet they can materially change the final project figure. That is why the headline build rate is only useful when paired with the wider delivery team. In a Wimbledon or Richmond scheme, coordination is not optional, it is part of the price of getting the work through without painful redesign later.


The practical lesson is simple. The cheaper-looking scheme can become the expensive one if it ignores planning risk, survey input, or the design time needed to make a difficult site work. Paying attention early usually protects the total budget later.

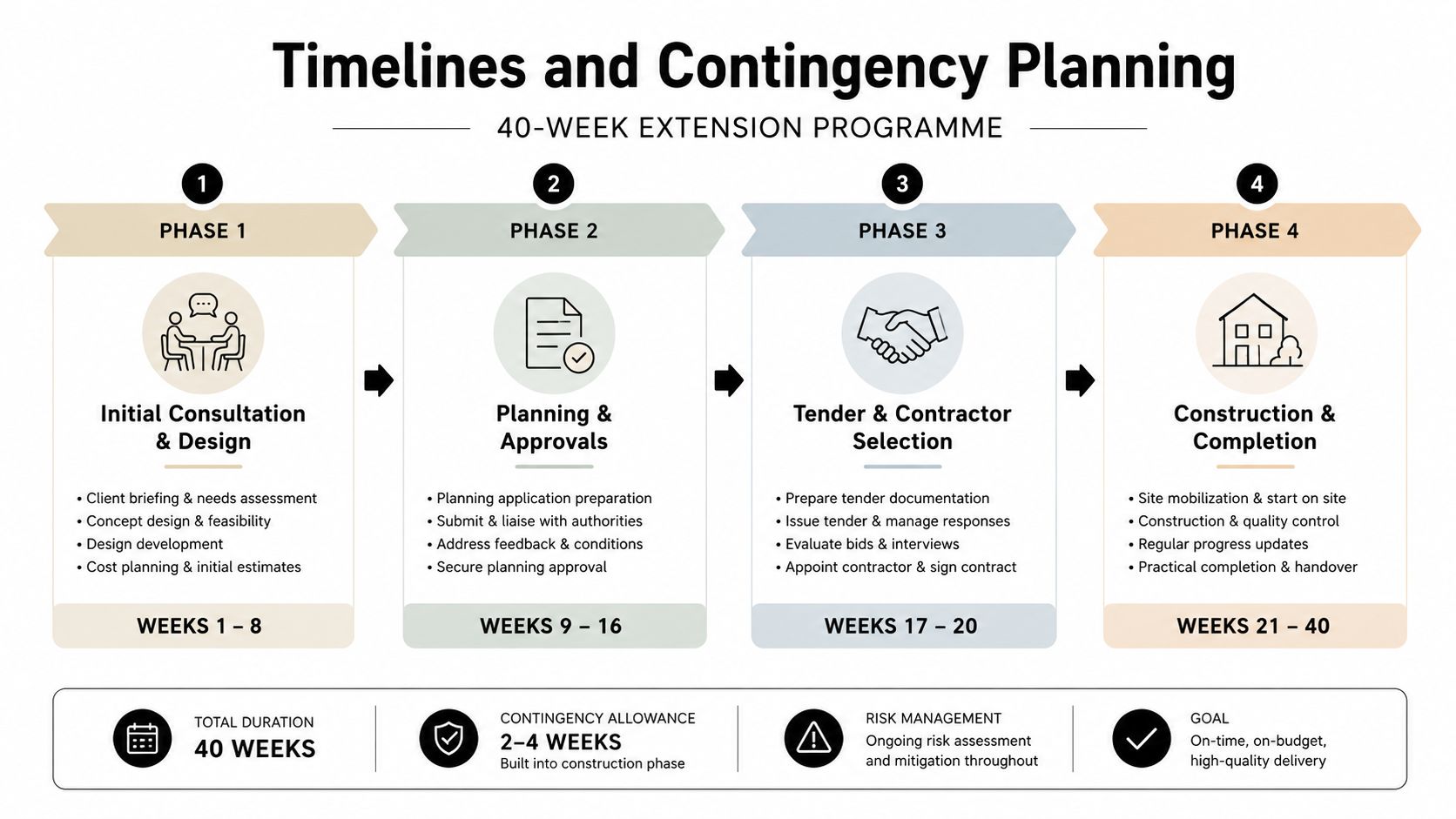

Timelines and Contingency Planning


A 40-week timeline infographic detailing the four phases of a construction extension project from design to completion.


A budget without a timeline is incomplete. Every month a project drifts tends to affect fees, procurement, and client decisions, and that is especially true when design changes keep arriving after the technical drawings are out. The clearest programmes I see are the ones that allow enough time for design, approvals, tendering, and build sequencing before anyone starts buying materials.


A realistic sequence


The early phase is concept and measured survey work, where the layout is tested and the brief gets sharpened. Then comes planning and technical design, which can be quick on simple schemes and slower where neighbours, heritage context, or policy issues enter the picture. Tendering and contractor selection then turn the drawings into a real price, and construction follows with snagging at the end.


Delays usually come from decisions made too late, not from the site itself.

The visual programme often used for a straightforward extension looks like this, a 40-week path from first consultation to completion, broken into Initial Consultation and Design, Planning and Approvals, Tender and Contractor Selection, and Construction and Completion. That is a planning tool, not a guarantee, but it is a far better reference than a vague “summer build” promise.


Why contingency is part of the design brief


A reserve of 10 to 15% is the standard contingency approach mentioned in UK guidance (Self Build & Design beginner guide). That reserve matters because hidden conditions, design development, and client changes are normal, not exceptional. Older South West London homes often justify a more cautious stance because their fabric and ground conditions can be less predictable.


The point is not to pad the budget carelessly. It is to stop a single unforeseen item from forcing a downgrade in the finishes that matter to daily life. If the contingency is left out, the project does not become cheaper, it just becomes more fragile.


The Case for Spending More Now Rather Than Less Later


A cheap extension can be the most expensive one over time if it needs rework, underperforms thermally, or feels disappointing the moment the paint dries. Recent UK guidance says a fabric-first approach that prioritises insulation and airtightness can add 15 to 30% to build cost, while a standard refurbishment may sit around £1,200 to £1,800 per m² by comparison (YouTube guidance reference). In a prime South West London context, that premium deserves serious thought.


Where the extra spend usually earns its keep


The best-value upgrades are the ones that improve the building envelope, the comfort of the room, and the quality of daily use. Better insulation, tighter detailing, and careful junction design are harder to see than joinery or flooring, but they shape how the house feels in January and July. That matters in a long-term home.


For many clients, the middle path is the sensible one. Spend properly on the things that are hard to change later, then protect the budget for visible finishes and external spaces that affect how the house reads and lives. A fully luxury specification is not necessary on every project, but a weak envelope is usually a false economy.


Not every home needs the same level of performance


There is a limit to how far a project needs to chase performance. Some homes want a very high-spec solution because the brief demands it, while others need a well-detailed extension that balances comfort and cost. The right answer depends on how long you plan to stay, what the house already gives you, and how much disruption you can tolerate during the build.


That is where a site-specific design conversation matters. In Wimbledon, the smartest spending is often the kind that avoids overheating, improves acoustic comfort, and reduces awkward compromises in layout. Those gains aren't flashy, but they tend to age well.


A higher upfront number is not automatically wasteful if it buys a better room, a better shell, and fewer regrets.

Building a Realistic Budget and Next Steps


A step by step guide on how to build a realistic construction budget for building projects.

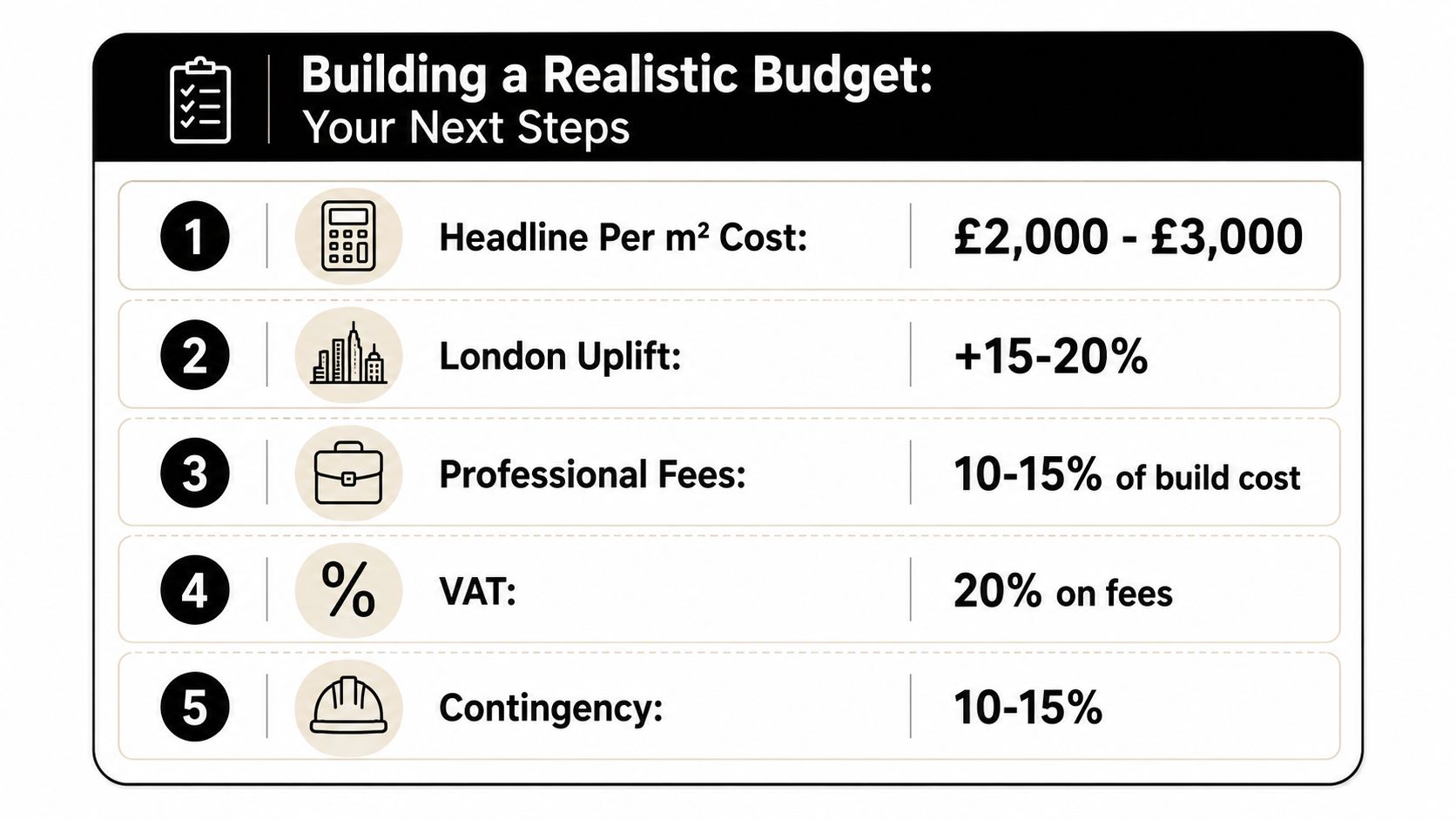

A proper budget starts with the headline build rate, then layers on the things that turn a design into a finished extension. Use the per m² range, then add a London allowance, professional fees, VAT, and contingency before you commit to a scheme. That order matters because it stops the first number you hear from becoming the number you believe.


A practical budgeting checklist


  • Headline build rate: start with the relevant per m² range for your type of extension and specification.

  • London uplift: expect a higher unit rate in South West London than in the UK baseline.

  • Professional fees: include architect, engineering, planning support, Party Wall, and building control.

  • VAT: add it separately, because it is not baked into every headline figure.

  • Contingency: keep a reserve of 10 to 15% so the project can absorb real-world issues.


The next step is to test the brief against the house itself. Get a measured survey, check title and lease constraints, review recent planning outcomes in the borough, and ask whether the layout really deserves the space you're proposing. A project that looks viable on paper can turn awkward if the boundaries, rights, or approvals are not checked early.


For homeowners in Wimbledon and across SW London, the most useful conversations are the ones that join design ambition to a hard budget. Harper Latter Architects works across extensions, basements, conservation, and high-end residential projects, so if you're weighing up a rear extension or a more ambitious transformation, visit Harper Latter Architects and arrange a conversation before the quote lines start to blur.






Comments


Harper Latter logo
Association logos

OFFICE

Common Ground

Hill Place House

55a High St

Wimbledon

London

SW19 5BA

Yell Review Us On Logo

Harper Latter Architects Ltd, registered as a limited company in England and Wales under company number: 13669979.  Registered Company Address: 3rd Floor, 24 Old Bond Street, London, W1S 4AP
