Tender Document Preparation: Secure Your Dream Builder

  • Writer: Harper Latter Architects
    Harper Latter Architects
  • 2 days ago
  • 13 min read

You've approved the design. The layout works, the materials feel right, and the house is beginning to look real on paper. The next decision is less visible, but it has as much impact on the final result as the architecture itself. You need to choose the builder who will turn that design into a finished home.


That choice shouldn't rest on instinct, a polished conversation, or a single attractive number at the bottom of a quote. In bespoke residential work, tender document preparation is what gives you a fair basis for comparison. It tells each contractor exactly what they are pricing, how they must return their bid, and what level of quality, care and coordination the project demands.


For high-end homes, this matters even more. A luxury refurbishment, listed building alteration, basement extension or new-build residence can't be procured like a commodity package. The documents need to communicate design intent, craftsmanship expectations and project risk with precision, otherwise you're not comparing like with like.


From Vision to Vetting Why Tendering Matters


By the time a project reaches tender, most clients want momentum. They've spent months refining plans, reviewing layouts and signing off finishes. It's tempting to treat the builder selection stage as a quick commercial exercise. In reality, it's the point where design quality is either protected or diluted.


Two professional architects reviewing building blueprints and tender documents on a wooden office table.


Why a formal tender protects a bespoke project


A proper tender process does three things at once. It creates competitive tension, it tests whether builders understand the project, and it exposes where assumptions sit before a contract is signed.


That last point is often the most valuable. A contractor may appear experienced and capable, yet still price the wrong level of finish, overlook coordination requirements, or make broad assumptions about specialist work. On a high-end residential project, those gaps become variation claims, programme pressure and avoidable friction on site.


The strongest tender packs don't just ask for a price. They ask the market to respond to a very specific brief. That is why the relationship between architect and builder matters so much during procurement, as explored in this piece on how architects and builders work together.


Generic bids are a warning sign


Generic responses are one of the clearest indicators that a contractor may not be right for a bespoke commission. For high-end architectural projects, as many as 40% of tenders can fail because they use generic responses that ignore a client's unique priorities, with buyers increasingly rejecting copy-paste submissions rather than project-specific proposals, according to this UK tender guidance for 2025.


That rings true in practice. A serious bidder will respond to the actual house, the actual site, and the actual constraints. They will recognise where heritage detailing, bespoke joinery, complex sequencing or neighbour sensitivity affects delivery. A weaker bidder will recycle standard wording and hope the price carries them through.


Practical rule: If a tender response could be used for a school, an office fit-out and your house without much editing, it isn't really a response to your project.

Tendering is about value, not just cost


Clients often assume tendering is mainly a mechanism for cost control. It is partly that, but cost is only one layer. Its primary purpose is to identify the builder who offers the best combination of pricing discipline, quality assurance, technical understanding and team fit.


On a bespoke home, “best value” can include craftsmanship, site management, attitude to detail, ability to coordinate specialist subcontractors, and respect for the design language of the project. A well-prepared tender package helps draw those differences into the open. Without it, contractors fill gaps in their own way, and the comparison quickly becomes unreliable.


Assembling the Core Information Pack


A tender is only as good as the information behind it. If the pack is incomplete, inconsistent or vague, even very capable builders will price different versions of the same project. That leads to uneven bids, awkward clarifications and a false sense of comparison.


The aim is simple. Every contractor should receive the same coordinated information, in the same format, with the same return requirements, so each one prices the same house.

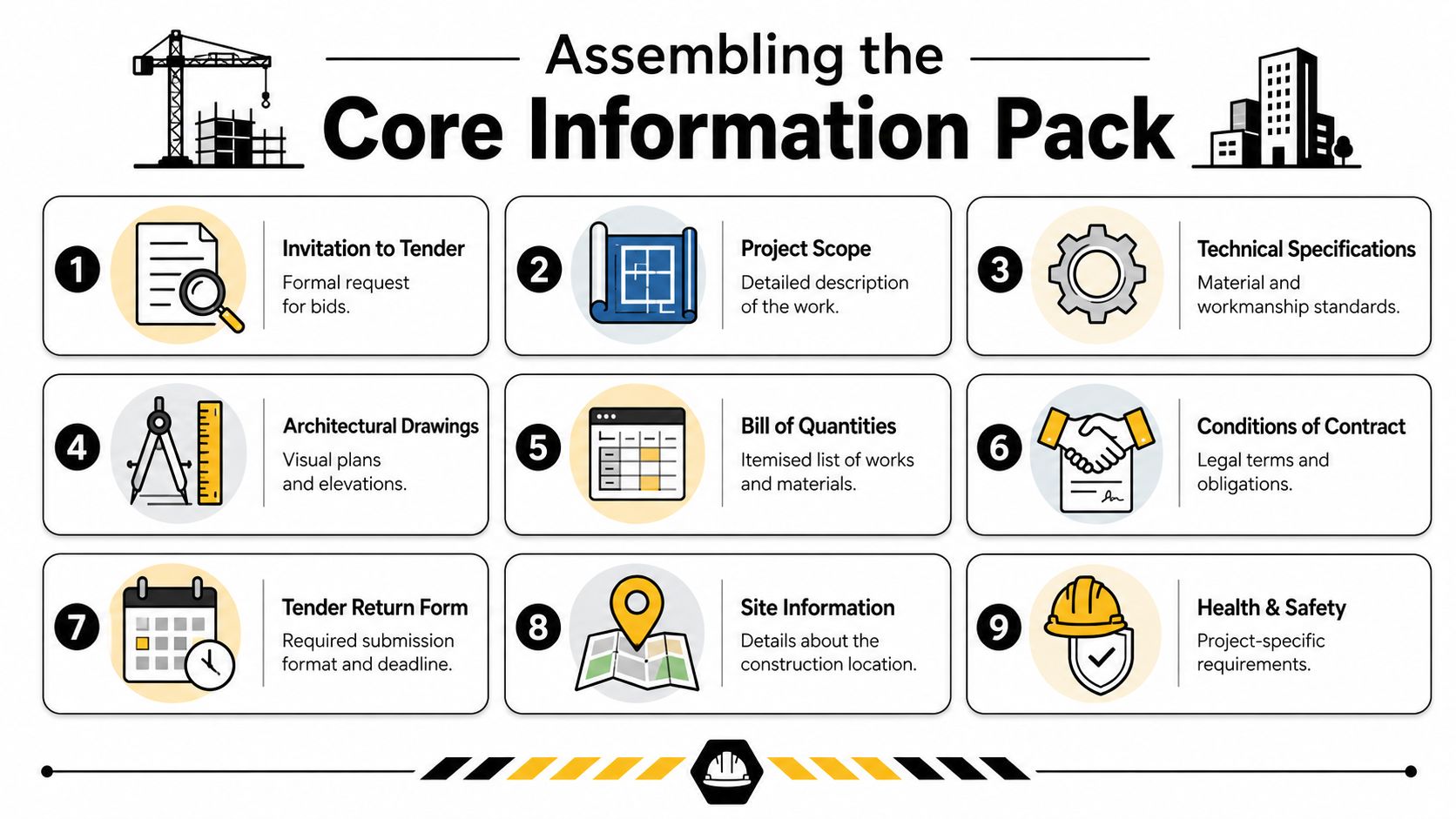

An infographic titled Assembling the Core Information Pack displaying nine essential construction tender document components.


The documents that define the project


For a bespoke residential tender, the core pack usually starts with the design information itself. That means the coordinated architectural drawings, structural information, and any relevant consultant packages such as lighting, kitchens, outdoor design or specialist audio-visual layouts where those elements affect pricing.


Alongside the drawings sits the written specification. The specification makes the project precise. It sets out materials, workmanship standards, product quality, interfaces between trades and expectations for execution. On a high-end scheme, the specification is often where the difference lies between “roughly this look” and “this exact standard”.


A robust pack commonly includes:


  • Invitation to Tender that sets the rules of the process, the return date, the bid format and any interview requirements.

  • Architectural drawings covering plans, elevations, sections, details and schedules.

  • Project specification describing materials, finishes, workmanship and installation standards.

  • Schedule of Works or trade breakdown so pricing can be compared clearly.

  • Site information including access constraints, party wall context, logistics limitations and neighbouring considerations.

  • Tender return form so bidders present prices and declarations consistently.

  • Contract information identifying the proposed form of building contract and key commercial assumptions.


Pre-qualification is not paperwork for its own sake


Clients sometimes see policy documents and company records as administrative padding. They aren't. They are part of basic professional due diligence.


A compliant UK tender pack must include mandatory documentation such as company CVs, key policies including health and safety, quality and environmental, financial accounts, accreditation certificates, and proof of insurance, and missing any of these items often results in immediate disqualification regardless of technical or financial merit, as set out in this guidance on preparing a compliant tender document.


That matters because the right builder is not just the one with the most attractive proposal. They also need the systems, financial standing and insurances to carry a complex residential project responsibly.


What works and what doesn't


A strong tender pack is coordinated and deliberate. A weak one is assembled in fragments.


Approach

What it leads to

Coordinated drawings and specification

Clearer pricing and fewer assumptions

Project-specific quality notes

Better understanding of finishes and detailing

Consistent return documents

Easier comparison across bidders

Loose email attachments from different stages

Confusion, omissions and uneven pricing

Generic schedules copied from past jobs

Misaligned bids and poor accountability


The more bespoke the house, the less room there is for generic documentation.

The hidden purpose of a complete pack


A complete information pack does more than help the contractor. It also protects the client from false economies. When every bidder prices the same thing, outliers become meaningful. If one price is lower, you can investigate why. If one bidder qualifies key elements, you can spot that early. If one contractor asks intelligent clarification questions, that often tells you something useful about how they will run the build.


In short, tender document preparation is not a filing exercise. It is the discipline that turns design information into a reliable procurement process.


Detailing the Financials Bills of Quantities and Contracts


Money problems in residential construction rarely begin with the final account. They usually begin much earlier, when pricing documents leave too much room for interpretation. If the financial framework is loose at tender stage, disagreements tend to surface later as “assumptions”, exclusions or unexpected extras.


That is why the pricing documents deserve as much care as the design set.


A professional in a business suit reviews and calculates costs using a bill of quantities document.


Why the Bill of Quantities matters


A Bill of Quantities is a structured pricing document that breaks the project into measured elements. Instead of asking a builder for one broad total, it requires them to price sections of work in detail. Groundworks, structure, roofing, glazing, joinery, finishes and services can all be costed in a way that makes review more transparent.


For clients, that has two major benefits. First, it improves comparability between bids. Second, it helps identify where a contractor may have underpriced, overallowed or misunderstood a package.


In bespoke homes, this level of detail can be particularly useful where there are unusual interfaces between trades. A basement with specialist waterproofing, a stone staircase, hand-finished plasterwork or integrated exterior retaining structures all benefit from careful breakdown rather than broad allowances.


Prime Cost Sums and Provisional Sums are not interchangeable


This is one of the most common areas of confusion. A Prime Cost Sum is usually an allowance for an item not yet finally selected, such as a sanitaryware package or decorative light fitting. A Provisional Sum is typically an allowance for work that is anticipated but not fully defined.


Those two categories must be separated clearly. In UK construction, ambiguity in financial documents is a leading cause of post-tender disputes, and 30 to 40% of tender failures stem from inaccurate quantity estimation or misunderstood specialist requirements rather than pricing alone, which is why the explicit separation of Provisional Sums and Prime Cost Sums is so important, according to this construction tender checklist.


Client safeguard: If an allowance appears in the tender, ask what it covers, what it excludes, and who carries the risk if the actual cost differs.

Pricing clarity reduces argument later


A sound tender package should make plain which costs are fixed, which are allowances, and which may move if further information emerges. It should also state how tender amendments will be issued and how builders are expected to acknowledge them.


For public sector tenders in the UK, the price must be stated in both words and figures, the currency must be clearly identified as GBP (£), and the submission must state whether the price includes VAT, as explained in this public sector tendering guide. Even on private residential projects, that level of clarity is good practice.


A short explainer can help when reviewing the commercial structure:


Financial item

Purpose

Fixed price items

Work clearly defined and priced as committed scope

Prime Cost Sums

Allowances for items not yet finally selected

Provisional Sums

Allowances for work not fully defined at tender stage

Preliminaries

Site management, welfare, protection, temporary works and overheads

Exclusions

Items the contractor has not priced and expects others to provide


After the numbers are in, proper contract administration during construction becomes the discipline that keeps those commercial assumptions under control.


The contract is part of the tender, not an afterthought


Many clients focus on price first and contract later. That can be expensive. The proposed building contract shapes payment procedures, programme obligations, extension of time provisions, insurance responsibilities and how variations are valued.


For residential work in the UK, common forms often derive from JCT contracts. The right choice depends on the size and complexity of the project, how complete the design is, and whether specialist packages will be finalised before or after appointment. What matters most is that the contractor tenders on the basis of a known contract form and understands the obligations that come with it.


A bidder who submits a competitive number while heavily qualifying the contract terms is not necessarily offering better value. They may be moving risk back to the client.


A useful overview sits below.



Defining the Process The Tender Timeline and Rules


Even an excellent tender pack can unravel if the process around it is rushed or poorly controlled. Contractors need enough time to review the documents, obtain specialist quotations, inspect the site and ask sensible questions. Clients need a process that is fair, structured and easy to audit.


When the timetable is too tight, bidders don't become more efficient. They become more defensive. They add contingencies, make assumptions or decline to tender altogether.

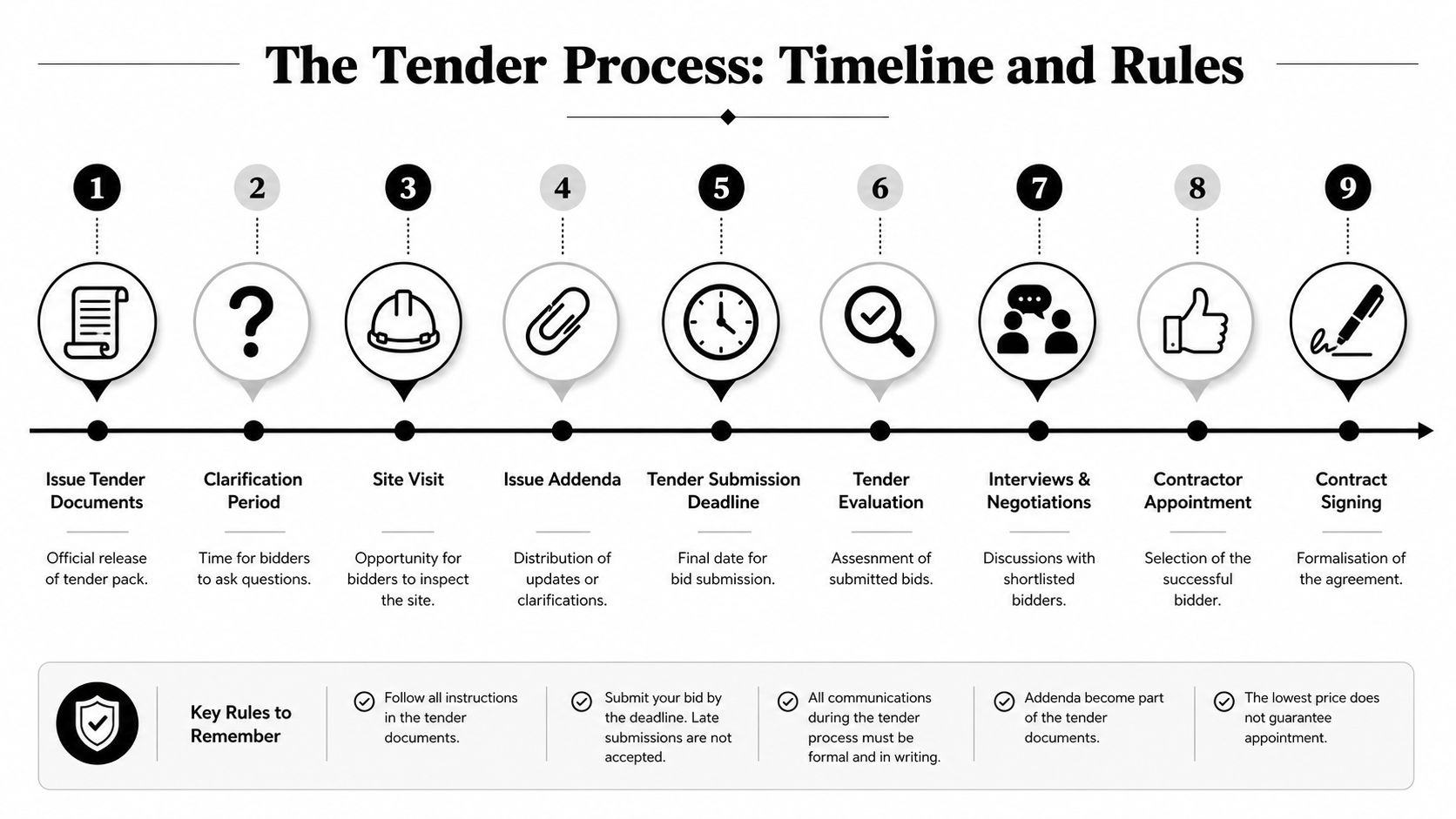

An infographic showing the nine stages of the tender process from document issuance to contract signing.


How long a proper tender should take


For complex UK projects, suppliers should be given 4 to 6 weeks to develop a tender, while smaller and more straightforward projects may only need 2 to 3 weeks, according to this guide to preparing a tender process. For a bespoke house with heritage constraints, intricate interiors or substantial structural work, the longer end of that range is usually more realistic.


That isn't indulgent. It allows contractors to do the work properly. They need time to speak with joiners, stone suppliers, mechanical subcontractors, glazing specialists and groundworks teams. If those conversations don't happen, the tender price is more likely to contain guesswork.


The rules should be explicit from day one


A good Invitation to Tender sets out the mechanics clearly. It should state the submission deadline, required format, whether the tender is to be returned electronically or in hard copy, who may ask clarification questions, and how answers will be circulated.


The internal programme matters as well. The tender response timeline typically works best when clarification questions are submitted within the first third of the available period, the first draft is completed by halfway through the response window, and at least 3 to 5 days are left for internal review before final editing begins no later than 2 days before the deadline, as outlined in these UK tendering best practices.


For clients, that timetable has a practical consequence. Questions tend to arise early, not the day before return. That means decisions on materials, scope boundaries or site access should be available promptly.


Don't let private side conversations creep into the process. If one bidder receives useful clarification, every bidder should receive it.

A straightforward chronology


A well-run tender often follows this sequence:


  1. Issue the tender pack with drawings, specification, return forms and contract information.

  2. Allow a clarification period during which questions are submitted through a single channel.

  3. Arrange site visits where appropriate, especially for refurbishments and constrained urban plots.

  4. Issue addenda if any part of the tender information changes or needs correction.

  5. Receive tenders by a fixed deadline in the format originally requested.

  6. Review compliance and pricing before shortlisting.

  7. Hold post-tender interviews if needed to test understanding and delivery approach.

  8. Appoint the preferred contractor and move to contract execution.


What clients can do during the tender window


The client's role is often understated at this stage. In practice, your availability helps keep momentum. If the architect needs prompt confirmation on a clarification point, a delayed answer can affect every bidder.


That said, discipline matters more than speed. The tender process works best when communications are centralised, documented and consistent. A contractor who tries to bypass that structure before appointment may be signalling how they will behave during the build.


Evaluating Tenders A Framework for Decision Making


When the bids come back, the lowest figure often grabs attention first. That's normal. It is also where many costly decisions begin.


A tender evaluation should test whether the contractor has priced the project accurately, understood the brief properly and demonstrated the capability to deliver the house at the standard required. Price matters, but without context it can mislead.


Start with compliance before comparison


A bid should first be checked for basic compliance. Has the contractor submitted all required documents? Have they answered the questions asked? Are the statements in the method sections consistent with the pricing and programme assumptions?


That discipline matters because 68% of unsuccessful construction bids fail due to missing compliance evidence or inconsistent claims, and high-scoring bids tend to confirm understanding, explain methodology clearly and provide supporting evidence, according to this analysis of bid improvement strategies.


A bid that looks attractive financially but is incomplete administratively is not a strong bid. It is a warning.


What a meaningful evaluation actually looks at


On a bespoke residential project, the review usually sits across several criteria at once:


  • Commercial accuracy. Are all packages priced, and are assumptions or exclusions clearly stated?

  • Technical understanding. Does the contractor grasp the sequencing, detailing and risk points of the actual project?

  • Relevant experience. Have they delivered comparable work in occupied homes, conservation settings or highly finished interiors?

  • Team quality. Who will run the site day to day, and how experienced is that person?

  • Professionalism of response. Is the bid coherent, structured and evidence-based, or vague and generic?


One useful benchmark is whether the contractor's response feels specific to the house. On luxury residential work, a bidder's reading of the design is often as revealing as the total sum.


Interview the builder, not just the bid


Post-tender interviews are where paper claims meet real people. This is the point to ask who will manage procurement of long-lead items, how quality control will be handled, how the site will be protected, and how programme pressure will be managed if specialist trades are delayed.


It is also the stage where personal fit becomes relevant. You're not merely buying a construction service. You're appointing a team that may be in and around your home for many months.


For clients who are trying to understand what distinguishes a contractor suited to this level of work, this guide to choosing the best luxury home builders is a useful companion.


The best tender response usually feels calm, precise and project-specific. It doesn't need theatrics to show competence.

Cheapest and best are rarely the same thing


A low bid can mean efficiency. It can also mean omission, optimistic allowances or a weak grasp of the drawings. At the other end, the highest bid is not automatically the safest. It may contain broad contingencies where the contractor hasn't worked hard enough to define risk.


The right decision often sits in the middle of the pricing range, with a contractor whose documents are clear, whose exclusions are limited, and whose interview confirms they understand both the house and the client.


Common Pitfalls and Your Role as the Client


Most tender problems aren't dramatic. They are small avoidable mistakes that stack up. An unfinished detail here, an unclear allowance there, a rushed return date, an attractive low price that hides key exclusions. None of them looks fatal on its own. Together, they create uncertainty at exactly the point the project needs confidence.


Clients can help avoid that. You don't need to run the tender, but your decisions and discipline shape how well it works.


The pitfalls worth watching closely


Some problems appear again and again in residential procurement:


  • Incomplete design information means builders fill gaps differently, so prices stop being comparable.

  • Over-short tender periods encourage assumptions rather than proper analysis.

  • Generic contractor responses usually signal weak engagement with the brief.

  • Unclear allowances around bespoke items often become disputes once procurement begins.

  • Informal side discussions undermine fairness and create inconsistent understanding between bidders.

  • Choosing solely on price can ignore capability, quality control and site management strength.


None of those issues is solved by working faster. They are solved by being clearer.


How clients strengthen the process


The most helpful clients during tender do three things well.


First, they stay available. When clarification points need answers, a prompt decision keeps the process moving and prevents contractors from pricing around uncertainty.


Second, they trust the formal route. Questions should go through the agreed channel, not private texts or ad hoc calls. That protects fairness and gives everyone the same information.


Third, they stay focused on value rather than headline cost. In bespoke work, the best builder is usually the one who understands the house properly, prices it transparently and inspires confidence in delivery.


A simple checklist can help:


Client action

Why it matters

Approve the tender pack carefully

Reduces gaps and assumptions before issue

Respond quickly to clarification points

Helps bidders price with confidence

Keep communication centralised

Preserves fairness and traceability

Attend interviews with an open mind

Tests team fit as well as price

Ask about exclusions and allowances

Exposes risk before contract signing


Tendering is part of design protection


This is the part many people only appreciate afterwards. Tender document preparation is not separate from design quality. It is one of the main ways design quality is defended.


If the documents don't articulate the standard of joinery, the care around heritage fabric, the sequencing of basement works, or the importance of final finishes, then the contractor is left to infer those things. Some will infer generously. Others won't. The tender stage is where those expectations should become explicit.


A well-run tender doesn't guarantee a perfect build. It does give the project a far better starting position, with fewer assumptions and a clearer basis for trust.

The client's role is to support that rigour. Ask questions. Review carefully. Be wary of bids that feel vague, hurried or too good to be true. And remember that appointing a builder is not just a commercial transaction. It is the moment your design moves from paper into somebody else's hands.



If you're planning a bespoke new build, luxury refurbishment, basement extension or heritage project, Harper Latter Architects can guide you through the tender process with the same care given to the design itself. From preparing coordinated tender information to helping evaluate builders for quality, fit and value, the practice supports clients in making confident decisions before construction begins.






Comments


Harper Latter logo
Association logos

OFFICE

Common Ground

Hill Place House

55a High St

Wimbledon

London

SW19 5BA

Yell Review Us On Logo

Harper Latter Architects Ltd, registered as a limited company in England and Wales under company number: 13669979.  Registered Company Address: 3rd Floor, 24 Old Bond Street, London, W1S 4AP

Terms of Use | Privacy & Cookie Policy | Trading Terms © 2024. The content on this website is owned by us and our licensors. Do not copy any content (including images) without our consent.

© Copyright
bottom of page
