Defects Liability Period: A UK Homeowner's Guide
- Harper Latter Architects

- 11 minutes ago
- 11 min read
You've just moved into the new extension, or maybe the contractor handed over the keys last week and the place still smells faintly of fresh paint. Then the first small issues start to appear, a sticky door, a hairline crack near a skirting board, a leaking valve under the sink, and suddenly the question is not whether the build looks finished, but what happens next.
That is where the defects liability period matters. It gives you a defined contractual window to live with the work, spot defects under real conditions, and ask the contractor to return and put things right. It is also where many homeowners get confused, because the end of that window does not necessarily mean the end of legal protection.
When a Finished Project Starts Raising Questions
A couple in South West London moves into a rear extension in early autumn. The contractor has gone, the snagging tape is off the floors, and the house finally feels like home. Two weeks later, they notice a door that won't close cleanly after the heating comes on, a patch of damp near a new shower enclosure, and a floor finish that sounds hollow in one corner.
That moment can feel awkward because the project is “done”, yet the building is only just being tested by daily life. The defects liability period exists for exactly that reason. It gives the homeowner and contractor a structured window to see how the work behaves once people are living in it, cooking in it, heating it, ventilating it, and using it normally.
Practical rule: if a defect only becomes obvious once the house is occupied, you need a clear contractual route for reporting it, not an informal promise that someone will “pop back soon”.
That route is especially useful on residential projects where trust is high but conditions are still unpredictable. Timber moves, seals settle, and new services are often pushed harder in the first months of use than they were during commissioning. A proper defects period doesn't turn a good relationship into a legal dispute, it gives both sides a fair, organised way to deal with issues while the contractor still has a duty to return.
If you're trying to understand how that handover should look in practice, a practical completion checklist is a good place to start, because the date of completion matters as much as the snag list itself. Practical completion checklist

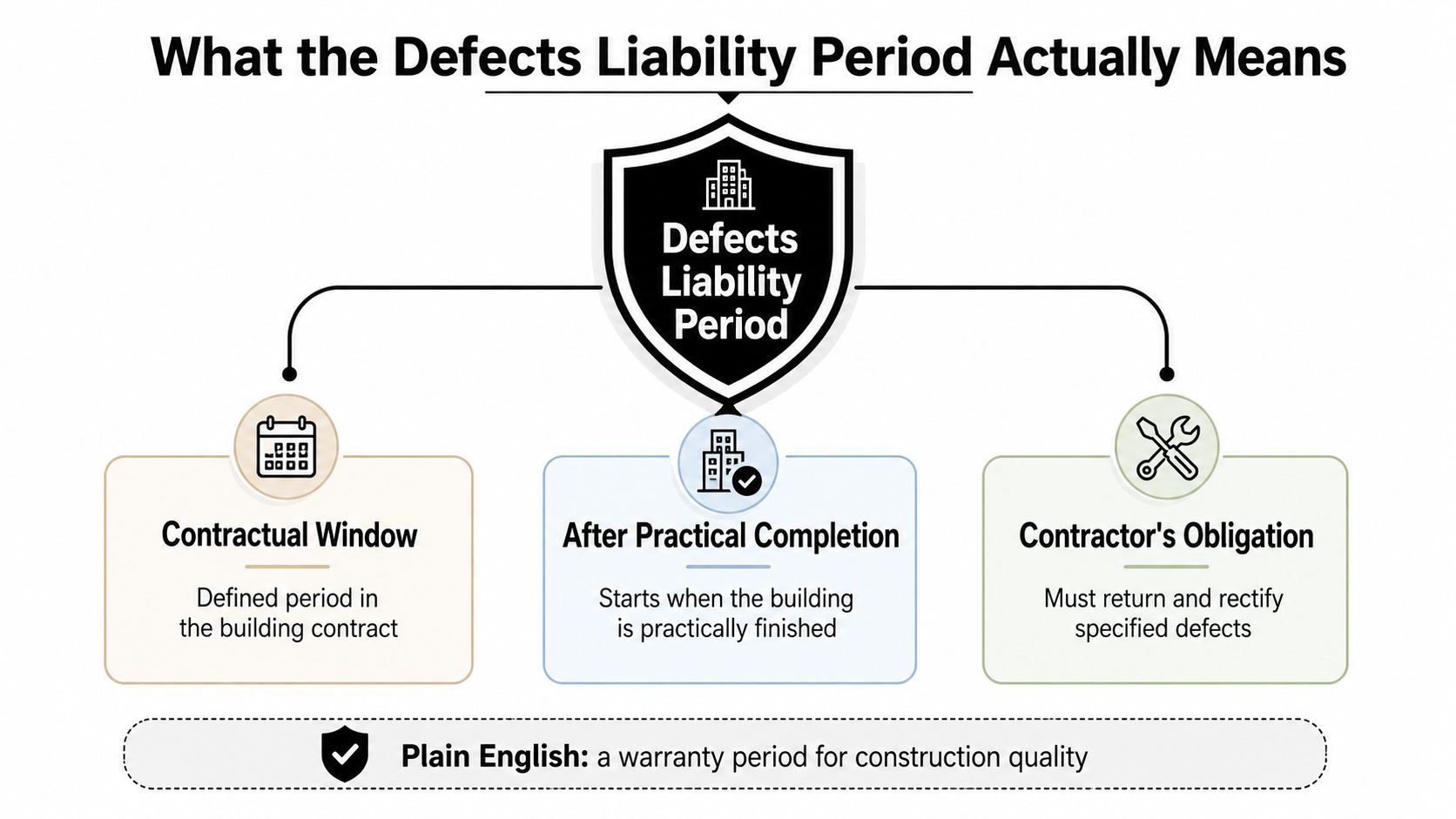

What the Defects Liability Period Means

A homeowner finishes a project, starts living in the space, and only then notices a shower tray that does not drain as intended, a joinery detail that opens up slightly, or a patch of paint that fails once the heating has been on for a while. The defects liability period is the contractual window that deals with that kind of problem. After practical completion, the contractor remains obliged to return and put right specified defects, so the building can be tested under normal use rather than only at handover.
In UK construction, that obligation comes from the contract, not from a general rule that applies to every job in the same way. Two homes can reach completion on the same day and still have different defect rights, because the wording in the building contract sets the scope, the timing, and the process.
Start date and purpose
The period normally begins at practical completion, not when you move furniture in, not when the cleaners finish, and not when the last payment is made. That distinction matters because practical completion is the contractual milestone, while occupation is the point when the house starts to be used in daily life.
Its purpose is focused. It allows defects in workmanship, materials, or other issues covered by the contract to be put right, but it does not give the homeowner a free route to request upgrades or routine maintenance. If a bathroom tile cracks because it was fixed poorly, that belongs in the defects process. If you later decide you prefer a different tile, that is a separate decision and a separate cost.
Why wording matters
RICS notes that contract particulars may set 12 or 24 months or more, and in some arrangements a period of six months applies if nothing is written down RICS defects and rectifications guidance. That is why the exact wording matters, because a familiar-sounding clause is not always the same as a clear one.
If the contract does not clearly say when the period starts and ends, do not assume everyone means the same thing.
For a homeowner, the safest approach is to treat the defects liability period as a planned review window. You are watching how the building behaves under real use and recording what needs attention while the contractor still has a contractual duty to return. It also sits alongside the completion papers, the snag list, and any retention arrangements, so it should be read as part of the wider contract package rather than in isolation.
That wider package matters because contract rights are only one layer of protection. A written defects period may end, but other UK statutory claim windows can continue to protect you if a more serious building problem later comes to light. In practice, that means the contractual snagging window is the first line of control, while the law may still offer a separate route much later if the issue is serious enough to fall within those longer claim periods.

How Long the Defects Liability Period Typically Lasts
A homeowner who opens the completion file often expects to find one neat answer to the question, “How long does the defects liability period last?” In practice, the answer depends on the contract, the scope of work, and how much time the project needs to show its weak points under real use.
The most common pattern in UK-style construction contracts is 12 months, because that usually covers one full cycle of occupation, weather, and seasonal movement. Some contracts set 12 or 24 months or more, while other arrangements may fall back to six months if the paperwork is silent PwC defects liability period overview. Complex engineering work can run longer still, although residential projects usually stay at the shorter end of that range.
Typical UK DLP durations by project type
Project type | Typical DLP length | Notes |
|---|---|---|
Straightforward rear extension | 12 months | Common residential arrangement, long enough to see seasonal movement and day-to-day use |
Bespoke new build or high-spec refurbishment | 12 months or longer | Duration may be negotiated if finishes, systems, or interfaces need extended observation |
Basement leisure suite or waterproofing-heavy project | 24 months or more | Often benefits from longer observation because failures can emerge slowly |
Heritage or listed refurbishment | 12 months or longer | Specialist materials and conservation details can need a longer review window |
A longer period gives defects more time to appear, which helps when the work includes items that do not reveal themselves quickly. It also shifts the commercial balance. The contractor remains exposed for longer, and that can feed into pricing and cashflow on negotiated work. On a private residential project, that trade-off may be worthwhile where the build includes complex waterproofing, bespoke joinery, or specialist detailing that benefits from a second seasonal check.
What to ask before you sign
Ask three direct questions. What date starts the period. How long does it last. What exactly counts as a defect.
Useful test: if the answer sounds vague in the meeting, it will probably be vague in the contract too.
That clarity matters more on high-value residential projects than many owners expect. A rear extension with standard finishes is one thing. A full refurbishment with plant, bespoke interiors, and delicate junctions between old and new fabric is another. The more complex the work, the more important it is to agree the period in writing rather than rely on habit or assumption.
A short contract window can still sit inside a much wider set of legal protections. The defects liability period is the immediate return visit, the time when the contractor is still expected to come back and put right items that should not have been left behind. Longer statutory claim windows may continue after that period ends, so a closed snagging list does not always mean the building is beyond challenge if a deeper defect appears later.
Why the Defects Liability Period Is Only Part of the Story

The contractual period is only the first layer. UK law keeps wider claim windows alive after the defects liability period ends, and that distinction is exactly where homeowners often underestimate their position. The end of snagging does not automatically mean the end of responsibility.
Under the Limitation Act 1980, claims on a simple contract are generally limited to 6 years, while deeds allow 12 years from completion AGS limitation periods guidance. Separately, the Defective Premises Act 1972 has been identified in academic literature as giving a 6-year liability period for defective premises work completed in the UK, and the Building Safety Act 2022 extended that limitation period for relevant claims to 15 years for existing claims and created a 15-year period for future claims in certain circumstances academic overview of the Defective Premises Act and Building Safety Act. That means a project can leave the contractual defect window and still remain exposed to legal action for years afterwards.
Why homeowners get caught out
A snagging period feels immediate and visible. Once the contractor has returned, the final account is settled, and retention is released, many people assume the matter is closed. It isn't always that simple. Ordinary breach of contract claims, deed-based claims, and Defective Premises Act claims can continue to matter long after the site team has gone home.
That distinction is particularly important on work where defects are slow to appear. Basements, waterproofing, and heritage refurbishments can behave normally at first and only reveal failure after a longer period of occupation. A leak behind a lined wall, movement in an old structure, or a moisture problem around a concealed junction may not become obvious during the first months after completion.
The practical takeaway is straightforward. The defects liability period is a rectification window, not the end of legal exposure. If you are commissioning a substantial residential project, keep completion records, snagging schedules, photographs, and handover documents in order, because they can matter long after the contractual period has expired.

Practical Steps for Homeowners During the Defects Liability Period
The best way to manage this period is to treat it as a sequence of decisions, not a pile of admin. First, establish what has been handed over. Then decide how defects will be recorded, who receives them, and how they are checked off when rectified.
An independent snagging survey can be useful before or immediately after occupation, especially on a high-spec build where joinery, finishes, and services all need close inspection. Once that survey is in hand, compile a written snagging list and send it to the contractor clearly, with dates, locations, and photographs where needed. Keep the language factual and specific, because that makes it harder for issues to be misunderstood.
Practical rule: if it can't be traced in writing, it can't be managed cleanly later.
How to keep the process moving
Record defects promptly: note what you see, when you saw it, and where it is in the building.
Notify in writing: email is usually better than a phone call because it creates a time-stamped record.
Allow access for rectification: the contractor can only fix what they can reach, so coordinate visits in good time.
Re-inspect before sign-off: don't close an item until you've seen the repair and checked the surrounding finish.
Track retention carefully: retention should be linked to completion of outstanding defects, not just the passage of time.
The final account should sit alongside this paper trail, not replace it. A clean record helps if a problem later becomes disputed, because the site history is already there: what was reported, what was fixed, and what still needs attention. That same documentation can also support the homeowner if a latent issue appears well after the defects period has ended.
For projects with a formal site administration structure, it helps to understand how the contract administrator keeps the process organised. Contract administration overview
The embedded walkthrough below is useful if you want to see the sequence in a more visual form.
Special Considerations for Luxury, Listed and Basement Projects
A standard defects period can work well on an ordinary extension. It needs more thought on specialist residential work. The reason is simple, the defects often hide in the details, and the details are the part of the building least clearly seen once someone has moved in.
Luxury new builds and bespoke interiors
On a luxury new build, defects are not always dramatic. A misaligned shadow gap, a poor junction between stone and timber, a concealed service fault, or an integrated lighting issue can all be defects without looking like obvious damage. The homeowner may only notice them once the house is lived in, cleaned, heated, and used at night as well as in daylight.
That is why integrated systems deserve a tighter handover process. AV, lighting controls, underfloor heating, comfort cooling, and joinery interfaces often need coordinated testing rather than a simple visual walk-through. The contract should reflect that reality so the defects period matches the complexity of the build.
Listed and heritage projects
Heritage work needs another layer of care. Approved repair methods, traditional materials, and consented details all affect how a defect is assessed and how it should be put right. A repair that looks acceptable on a modern house may be wrong for a listed building if it changes the character of the fabric or uses the wrong material.
The contract therefore needs to sit comfortably with specialist approvals and any project-specific warranty or conservation requirements. If the wrong repair method is used, the question is not just whether the defect has been fixed, but whether it has been fixed in a way that respects the building's status and long-term behaviour.
Basements and waterproofing-heavy work
Basements are the clearest example of why time matters. Waterproofing, drainage, and mechanical systems can work perfectly on handover day and still fail later under different conditions. Moisture movement is often slow, hidden, and expensive to trace.
Basements need patient observation, because the first sign of a defect is often a stain, an odour, or a control issue, not a dramatic leak.
That makes staged inspection useful. It also makes a longer contractual review window worth discussing, particularly where the project depends on pumps, membranes, or complex drainage routes. In short, the more serious the consequences of failure, the more carefully the defects period should be written and monitored.
Contract Clause Checklist and Sample Wording
Before signing, read the defects clause as if you were going to rely on it later, because you probably will. The wording should tell you when the period begins, how long it lasts, how defects are reported, and what happens if the contractor disputes responsibility.

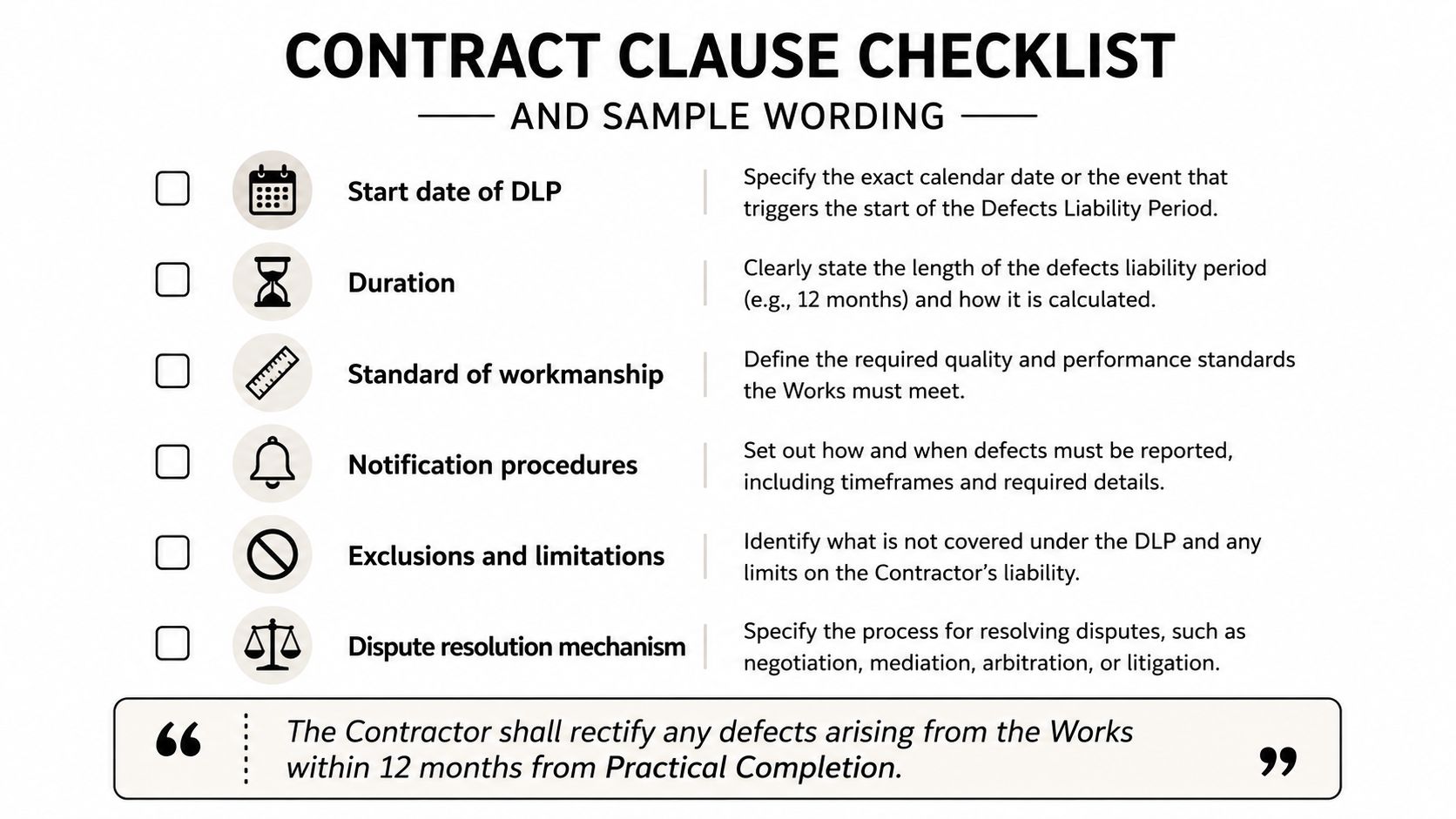

What to check in the clause
Start date of the defects liability period: confirm whether it runs from practical completion, handover, or another defined milestone.
Duration: make sure the number of months is written plainly and matches what was agreed in meetings.
Standard of workmanship: check what standard the contractor must meet when carrying out rectification.
Notification procedure: look for the method, format, and recipient for defect notices.
Exclusions and limitations: see what is excluded, because not every defect clause is as broad as it sounds.
Retention and release: confirm how much retention is held and when it is released.
Dispute resolution mechanism: identify what happens if the contractor and homeowner disagree about a defect.
A sensible starting point for discussion could be this:
“The Contractor shall rectify any defects arising from the Works within 12 months from Practical Completion.”
That sentence is not legal advice, and it shouldn't be copied blindly into every contract. It is a conversation prompt, useful because it is short, clear, and easy to test against the rest of the paperwork. If the contractor or solicitor changes the wording, ask why, and ask whether the change affects the start date, the scope of defects, or the right to withhold retention.
For projects with a more structured tender process, clause clarity should be checked before the contract is awarded, not after site work has started. Tender document preparation guidance
Bringing It All Together as a Homeowner
Read the defects clause before you sign. Plan a snagging survey. Keep everything in writing. Treat retention as working capital, not a gift. And remember that statutory protection can last far longer than the contractual defects liability period.
The best projects use that period properly. It isn't a loophole or a nuisance, it's a structured chance to test the building under real conditions while the builder still has a formal duty to return. Bring your architect and solicitor into the conversation early, because clear records and clear wording save time, money, and stress later.
If you're planning a new build, refurbishment, basement, or heritage project in South West London or Surrey, Harper Latter Architects can help you set up the contract, handover, and post-completion process with care from the outset. Visit Harper Latter Architects to discuss a project where the paperwork, site process, and building quality all work together.
